All quiet on site...

It's now two weeks since the floor slab was poured with most of the ground floor plumbing and underfloor heating pipes in-situ. The planning and preparation work appears to have paid off as overnight rain reveals little ponding of water indicating we have a flat and level slab within the specified tolerance. All services are also now in place within the slab, having been 'introduced' to the inside of the building via pipework and ducts, with just the soil pipes to be revealed by tapping away the few mm of concrete over their sealing caps. Little has happened since on site with the exception of the delivery of the timber frame sole plate material to be fitted in readiness for the main house frame, this being schduled for delivery w/c 29th October, although there has been much 'to-ing' and 'fro-ing' between frame supplier, builder, architect and client (us!) over minor changes to dimensions of components and materials. In the meantime, we've put some more effort into landscaping works and have started to plant up behind the drystone faced retaining wall, this being almost complete bar coping stones (proving quite hard to come by!).

End of week 3

The lack of a posting for the last six days hasn't been because a lack of activity at ECF - far from it...! Building works on the house have continued on apace, whilst the hens and windfarm development have provided a welcome diversion from a busy site!


After the 200mm floor insulation was laid on Monday the damp proof membrane went down and the reinforcement mesh was cut and laid on top, supported on 40mm spacers to set them at the required depth within the slab. On Tuesday the heating contractors arrrived to tie the pipes to the mesh, but on investigating what seemed a minor query by the builder in respect of the structural drawings at the end of the day it was clear that we had a problem.

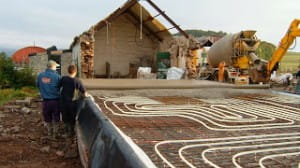

With about 70% of the heating pipes laid, it turned out that the reinforcement mesh to which they were tied had been laid incorrectly and needed to be rotated by 90 deg. in plan. The floor slab was designed to use a 'uni-directional' mesh which is stronger in tension in one direction than the other - and guess what....! To be fair to builder and architect, it simply wasn't obvious from the structural drawings and on Wednesday everyone simply got on with dealing with the problem and close of play saw the project at a similar stage as 24hrs earlier - albeit with the mesh now correctly orientated. It was a gloomy day however, as whilst there was little material wastage, all of the underfloorheating pipes had to be pulled off and re-tied along with all the mesh which had to be removed and re-cut.


By Friday everyone had moved on and at 0745 a large crew had gathered on site awaiting the first of three deliveries of concrete, which subsequelty arrived at 0800 - bang on schedule. With expansion strips fitted to the inside edge of the slab 'form' and a top layer of reinforcement placed over supporting wall points, the resident digger started to scoop the concrete onto the previous three weeks work. A 'bunyan striker' bar (a huge rotating roller) was used to level/vibrate/compact this sloppy mix into the mesh/pipes. By late morning th whole lot was poured and levelled and the crew got on with finishing off the rest of ground works. The afternoon was spent further levelling the concrete by hand and by 5pm the job was done.


In all 21 cu.m of concrete was used, 95% of which is supported on packing foam! This will add 'thermal mass' to the building and help to ensure a stable, comfortable internal temperature.

Day 11...


Since Debs' post this morning, by the time the crew left at the end of the working day the hardcore and type 1 material was in with sand blinding on top ready for the insulation to be installed. This point marks the first departure from conventionality, as the next stage is to install 200mm of polystyrene insulation ready for the 20 tonnes of concrete slab to be poured on top of it.
Usual practice is to pour the slab at this stage, then insulate it and pour 50-70mm of screed on top within which the underfloor heating pipes are installed. We're cutting out the screed and going for a single pour of 150mm, which will will also contain the underfloor heating pipes within this massive slab.

The theory behind this is that we will be using a lightweight (timber frame) structure to build the house, this being common practice in Scotland and fairly standard in Scandinavian countries and North America. Whilst there are many advantages of timber frame construction over heavyweight masonry, well insulated timber buildings can be liable to overheating in summer and internal temperature/comfort levels can be difficult to stabilise. Introducing 'thermal mass' elements into the structure compensate for this...which is where the heavyweight floor slab comes in. In addition we have specified high density wood fibre and mineral wool insulation for the walls and roof which will also add to the thermal mass of the building as a whole.

Chilly Morning

Last night we had our first true frost. The air temp hit freezing outside the caravan and the lowest point inside was 4.8 deg C -the hard part is surfacing from under the duvet. The views are fabulous today, its very easy to see where the big windows of the house will look out to.

More hardcore arriving today to form the base for the insulation and then the concrete pour, both of whihc will happen next week. The timber frame will be about a week late so after next week not much will happen on site. We are really pleased at progress so far. It is a year ago this week that we purchased this place so it feels good to be out of the ground one year on.
